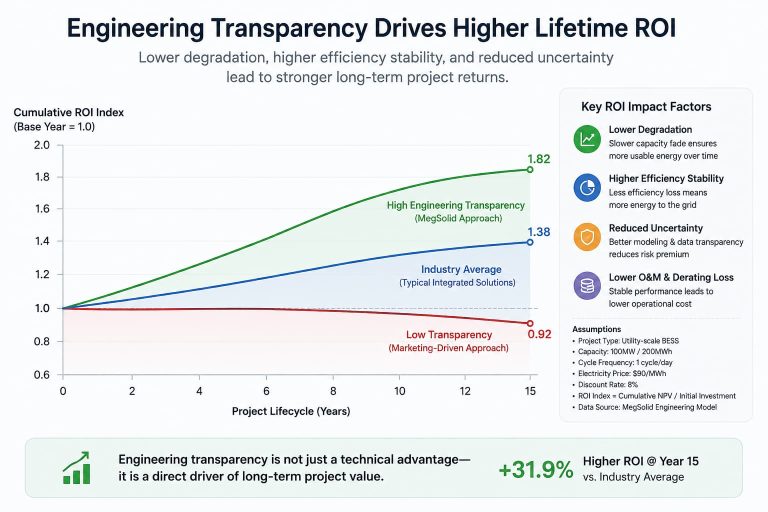

Download Technical Specs PDF

Engineering the 5MWh BESS: A Deep Dive into MegSolid’s 5000INTL Containerized Architecture

As utility-scale projects and large-scale microgrid deployments accelerate globally, EPC contractors and energy developers face increasing engineering complexities. Integrating megawatt-hours of energy storage requires mastering high-voltage DC topologies, advanced thermal management, and extreme environment resilience.

While standard outdoor cabinet ESS solutions excel in commercial peak shaving, utility-scale demands require a fundamentally different architecture. Founded in 2018, MegSolid (SOLID ESS) addresses this through its flagship Meg Solid Energon 5000INTL, a 5MWh containerized energy storage system built on proprietary Hybrid Solid-State Battery Technology.

This engineering analysis deconstructs the 5000INTL’s system topology, thermal design, and grid-tied integration, providing B2B project developers with the technical context needed for utility-scale deployment.

High-Voltage Topology: Why 1331.2 Vdc Matters

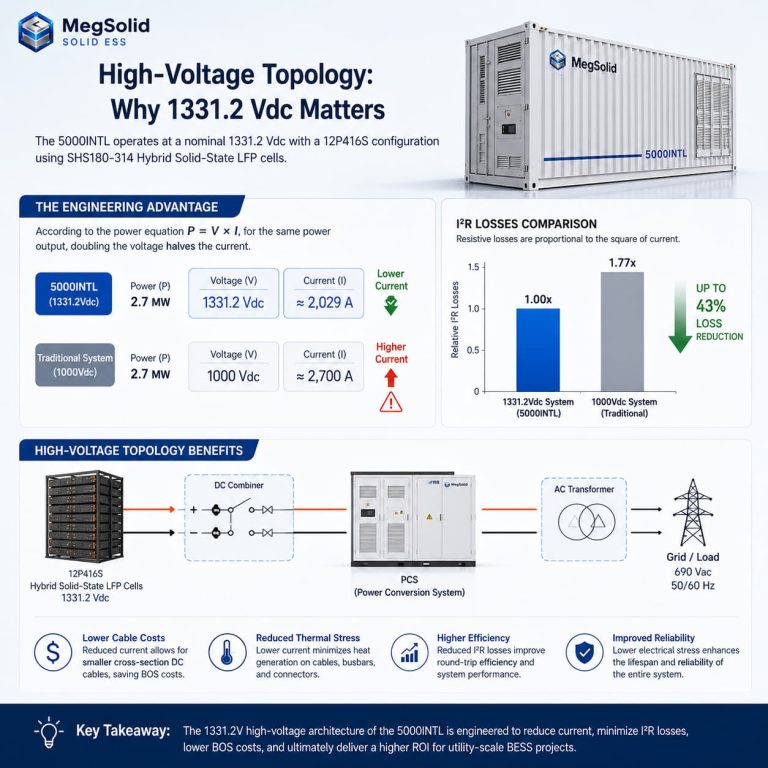

In utility-scale BESS design, increasing the DC system voltage is a critical strategy to reduce balance-of-system (BOS) costs and improve round-trip efficiency. The 5000INTL operates at a nominal 1331.2 Vdc with a 12P416S configuration using SHS180-314 Hybrid Solid-State LFP cells.

Engineering Explanation

According to the power equation $P = V × I, for the same power output, doubling the voltage halves the current. By utilizing a 1331.2V DC architecture instead of the traditional 1000V systems, the 5000INTL significantly reduces the current flowing through DC cables and the Power Conversion System (PCS).

This reduction in current exponentially decreases resistive losses ($I^2R$ losses) in the cabling. Furthermore, the lower current allows for the use of smaller cross-section DC cables and lower-rated DC contactors, reducing BOS copper costs while minimizing thermal stress on the busbars.

Thermal Management: AI-Driven Liquid Cooling in 5MWh Density

Packing 5015.9 kWh of energy into a standard 20-foot container creates immense thermal density. Traditional air-cooling is insufficient and often leads to temperature gradients exceeding 5-8°C across the battery racks, which accelerates degradation and risks thermal runaway propagation.

The ±5°C Engineering Imperative

MegSolid engineers the 5000INTL with an intelligent liquid cooling system governed by advanced self-evolving algorithms. The engineering target is strict: maintain a temperature difference of ≤±5°C across the entire battery rack.

Safety Architecture & UL9540A

In a 5MWh system, mitigating thermal runaway propagation is paramount. MegSolid significantly reduces the probability of propagation compared to conventional liquid electrolytes by utilizing a stable solid electrolyte matrix. This intrinsic safety architecture is designed according to UL9540A evaluation methodology, aiming to mitigate cell-to-cell propagation. (For foundational knowledge on cell-level safety, refer to our BESS thermal runaway prevention guide).

Extreme Environment & Grid-Tied Compliance

Utility-scale projects are frequently deployed in harsh environments where grid infrastructure is weak. The 5000INTL is engineered for these exact edge-case scenarios.

1. High-Altitude Derating Mitigation (4000m)

At altitudes up to 4,000 meters, air density drops by approximately 30%. This reduces the dielectric strength of the air and the convective cooling capacity. The 5000INTL’s PCS and liquid cooling loops are specifically designed with altitude derating in mind. The pressurized liquid cooling loop is unaffected by air density, ensuring the battery rack remains within optimal thermal bounds even when the external air is too thin for effective passive heat rejection.

2. Grid-Forming & ToU Arbitrage

The system delivers a rated AC power of 450*6 kW (690 Vac, 50/60 Hz). The integrated MegSolid PCS supports both grid-following and grid-forming modes. For projects in areas with unstable grids, the <20ms charge/discharge switching time ensures microgrid stability and uninterrupted power supply for critical industrial loads, maximizing peak shaving ROI.

Product Comparison: 215kWh Outdoor Cabinet vs. 5000INTL Containerized ESS

Selecting the correct architecture depends on project scale, grid connection requirements, and footprint constraints. Below is an objective engineering comparison between MegSolid’s C&I and Utility-scale flagships.

Engineering Feature
ESSA0100B-0215 (Outdoor Cabinet)
5000INTL (Containerized ESS)
Application Scale
C&I Peak Shaving, Microgrid Backup
Utility-Scale, Heavy Industrial, Grid Balancing
Rated Energy
215.04 kWh
5015.9 kWh (5MWh)
DC Voltage Topology
768V (1P240S)
1331.2V (12P416S)
Cooling Methodology
Intelligent Air Cooling
Intelligent Liquid Cooling (±5°C)
AC Power
100 kW
2700 kW (450*6 kW)
Max Efficiency
High (C&I standard)
87.5% (Utility-scale optimized)
Protection Rating
IP54
IP55 (Higher dust/water ingress protection)
Altitude Capability
Standard Industrial
≤ 4000m (Compensated for low air density)
Deployment Complexity
Low (Plug-and-play)
High (Requires HV commissioning, foundation prep)

MegSolid Authority & Turnkey Scalability

MegSolid is a world-class integrated energy storage technology enterprise with a dedicated team of 50+ battery and PCS engineers. Our advanced manufacturing facilities in Huzhou, China, are capable of delivering GWh-scale annual production. We provide comprehensive OEM/ODM manufacturing for custom containerized ESS design, tailored to regional grid codes and compliance standards (e.g., CE, UL, IEC).

References & Industry Standards

MegSolid's engineering design and testing protocols for utility-scale ESS align with the following international standards:

FAQ

A 1331.2V DC system reduces the current required for the same power output. This exponentially decreases I²R resistive losses in DC cables and the PCS, improving round-trip efficiency and reducing balance-of-system copper costs.

The system uses self-evolving algorithms to modulate coolant pump speed based on real-time thermal data from the BMS. The high heat transfer coefficient of the liquid coolant rapidly extracts heat from the cell modules, preventing localized hotspots and ensuring uniform State of Health (SOH).

Yes. While air density drops at high altitudes, reducing air-cooling efficiency, the 5000INTL utilizes a pressurized liquid cooling loop that is independent of external air density. This ensures the battery rack remains within optimal thermal bounds without derating.

The 12P416S configuration (12 parallel strings of 416 cells in series) optimizes the voltage and capacity balance for utility-scale deployment. It allows the system to reach the 1331.2Vdc threshold necessary for efficient PCS operation while delivering 5015.9 kWh of usable energy.

The system is designed according to UL9540A evaluation methodology. The proprietary Hybrid Solid-State LFP cells utilize a stable solid electrolyte matrix, which significantly reduces the probability of thermal runaway propagation compared to conventional liquid electrolytes.

The 5000INTL containerized ESS achieves a maximum system efficiency of 87.5%, optimized for continuous heavy-cycle commercial and utility-scale deployments.

Yes. The integrated MegSolid PCS supports both grid-following and grid-forming modes, with an ultra-fast <20ms charge/discharge switching time, making it ideal for microgrid stability and unstable grid environments.

The containerized system features an IP55 protection rating, providing superior resistance to dust and water ingress for demanding outdoor utility-scale environments.

By utilizing intelligent liquid cooling instead of constant-speed air-cooling fans, the system modulates cooling power based on actual thermal load. This reduces auxiliary power consumption by up to 30% compared to traditional air-cooled systems.

Yes. We offer comprehensive OEM/ODM manufacturing, including custom container layout, PCS integration, and battery rack design, tailored to meet specific regional grid codes and project requirements.
