Battery Energy Storage System Factory Acceptance Test (FAT): The Complete EPC Witness Guide Before Shipment

Selecting a Battery Energy Storage System (BESS) supplier is only the beginning of the procurement process. The most expensive project failures often occur after the purchase order has been issued but before the equipment leaves the factory. A Factory Acceptance Test (FAT) is the final opportunity for EPC contractors, system integrators, and project owners to verify that the delivered system performs exactly as specified.

Unfortunately, many FAT inspections are reduced to simple demonstrations. Suppliers power up the cabinet, display several HMI screens, perform a short charging cycle, and declare the system ready for shipment. While this may satisfy a contractual milestone, it rarely validates the engineering performance that determines long-term project reliability.

For commercial and industrial Battery Energy Storage Systems, a proper FAT should confirm far more than basic functionality. It should verify power conversion performance, battery management logic, communication integrity, safety interlocks, protection strategies, thermal management, and compliance with the approved project documentation. Every unresolved issue discovered after shipment can translate into commissioning delays, additional site visits, contractual disputes, and unnecessary project costs.

This guide explains how EPC engineers should witness a Battery Energy Storage System Factory Acceptance Test, what documents must be reviewed before arriving at the factory, and which engineering tests should never be skipped before authorizing shipment.

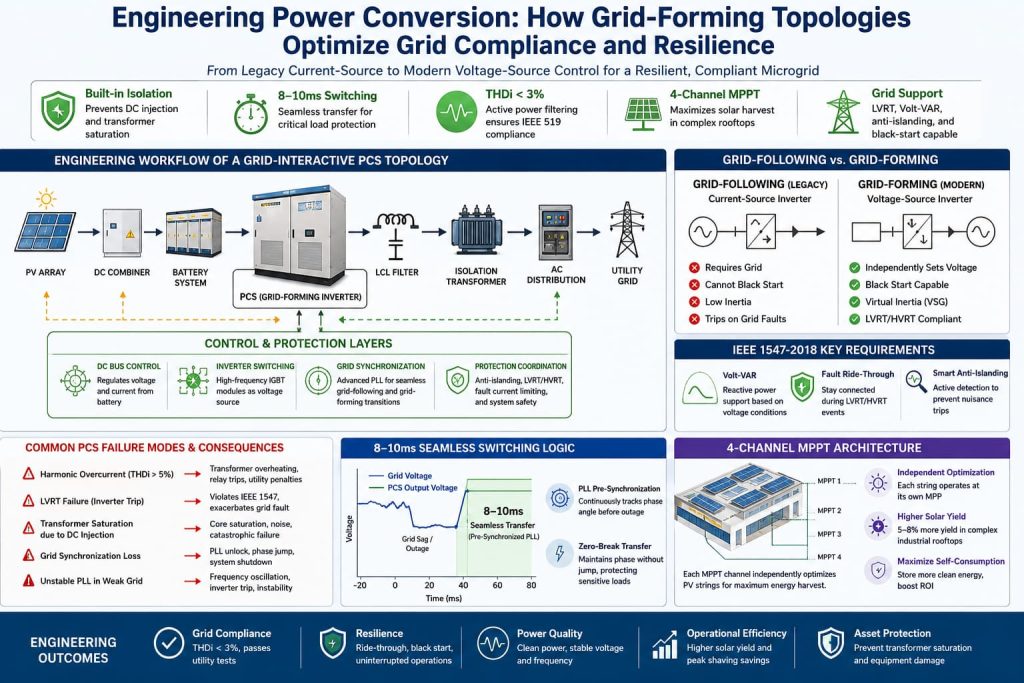

Detailed technical infographic comparing grid-following versus MegSolid grid-forming voltage-source PCS topologies. It illustrates the complete grid-interactive electrical workflow, IEEE 1547 fault ride-through requirements, and pre-synchronized 8-10ms transfer wave diagrams.

Why a Factory Acceptance Test Is More Valuable Than a Product Datasheet

A product datasheet describes what a Battery Energy Storage System is designed to achieve under specified operating conditions. It does not demonstrate that the assembled system delivered to your project actually meets those specifications.

Many procurement teams spend weeks comparing battery capacity, PCS ratings, cooling methods, certifications, and enclosure protection levels. These comparisons are important during supplier selection, but they cannot replace functional verification performed on the completed system.

For example, two suppliers may specify identical battery capacities, similar PCS power ratings, and the same communication protocols. However, the assembled systems may behave very differently during grid simulation, emergency shutdown, or load transition testing because of differences in firmware integration, BMS logic, EMS programming, or commissioning quality.

A comprehensive FAT allows EPC engineers to verify whether every subsystem functions together as an integrated solution rather than as independent components.

During a professional FAT, engineers should confirm:

Unlike laboratory testing performed on individual components, FAT validates the actual system that will be installed on site.

For projects involving commercial energy storage, this verification is significantly more valuable than reviewing additional marketing literature.

Engineers responsible for supplier qualification should also review whether the manufacturer maintains standardized production processes, engineering documentation, and integrated testing capabilities before shipment.

For buyers evaluating integrated storage solutions, understanding the manufacturer's engineering capability is just as important as comparing hardware specifications.

You can learn more about integrated commercial storage platforms through Commercial & Industrial Energy Storage Systems, which illustrates how complete BESS architectures differ from individual battery component procurement.

Engineering Documents That Should Be Reviewed Before Visiting the Factory

A successful FAT begins long before engineers arrive at the manufacturing facility.

One of the most common procurement mistakes is treating FAT as an on-site inspection instead of a structured engineering verification process. Without reviewing technical documentation in advance, engineers often spend valuable factory time searching for missing drawings rather than validating system performance.

Before scheduling the FAT, EPC teams should request a complete documentation package from the manufacturer.

This package typically includes:

Every document should match the final production configuration.

For example, the battery model listed in the BOM should match the installed battery modules. PCS firmware versions should correspond to the approved software revision. Communication addresses, Modbus mapping, and controller configurations should remain consistent throughout the project documentation.

Any discrepancies identified before factory testing should be resolved before functional verification begins.

For integrated systems that combine batteries, PCS, EMS, and power distribution equipment, reviewing these engineering documents significantly reduces the likelihood of discovering configuration conflicts during commissioning.

Manufacturers capable of supplying complete integrated systems generally maintain standardized engineering documentation across both outdoor cabinet systems and containerized energy storage platforms, making FAT preparation considerably more efficient.

For example, outdoor cabinet solutions such as Outdoor Cabinet Energy Storage Systems and larger Containerized Battery Energy Storage Systems require different inspection priorities because of their electrical architecture, thermal management design, and commissioning procedures.

The 5 FAT Verifications That Reveal Most Integration Problems

Not every Factory Acceptance Test provides the same value. Some manufacturers only demonstrate that the system powers on, while others perform comprehensive engineering validation under realistic operating conditions.

For EPC contractors, the objective is not to witness as many tests as possible. It is to verify the five areas most likely to cause commissioning delays, performance issues, and warranty disputes after shipment.

1. Verify PCS Performance Under Real Operating Conditions

The PCS should be tested beyond basic start-up and shutdown. During the FAT, engineers should confirm stable charging and discharging, active and reactive power control, emergency stop response, and fault recovery. If possible, the manufacturer should demonstrate operation under simulated load rather than a no-load demonstration.

Where modular PCS architectures are used, communication between each PCS module and the master controller should also be verified. Learn more about Modular Energy Storage PCS for commercial BESS applications.

2. Confirm BMS and EMS Work as One System

Many commissioning problems originate from software integration rather than battery hardware.

Instead of reviewing screenshots, ask the manufacturer to demonstrate complete operating scenarios, including PV priority, peak shaving, backup mode, grid recovery, and zero-export control. At the same time, verify that the BMS accurately reports cell voltage, temperature, SOC, alarms, and communicates correctly with the PCS and EMS.

A FAT should prove that every subsystem functions as an integrated platform rather than independent components.

3. Simulate Real Grid Events

Laboratory conditions rarely reflect actual project environments. A professional FAT should include grid loss, voltage and frequency fluctuations, islanding, automatic reconnection, and backup transition.

These tests demonstrate whether the Battery Energy Storage System can maintain stable operation when utility conditions change, which is often impossible to verify from a datasheet alone.

4. Validate Safety and Thermal Protection

Safety verification should extend beyond checking whether fire protection equipment is installed.

Engineers should witness the complete protection sequence, including smoke and temperature detection, emergency shutdown logic, alarm generation, cooling system response, and event recording.

For liquid-cooled systems, pump operation, coolant circulation, and thermal control strategies should also be demonstrated. Manufacturers offering integrated Liquid-Cooled C&I Energy Storage Systems should be able to verify these functions before shipment.

5. Review FAT Records Before Approving Shipment

The final acceptance should focus on engineering documentation as much as equipment performance.

Before authorizing shipment, EPC teams should confirm that the manufacturer provides complete FAT reports, calibration records, software versions, communication test results, updated drawings, and a documented list of any corrective actions. Every tested configuration should match the equipment that will be delivered to site.

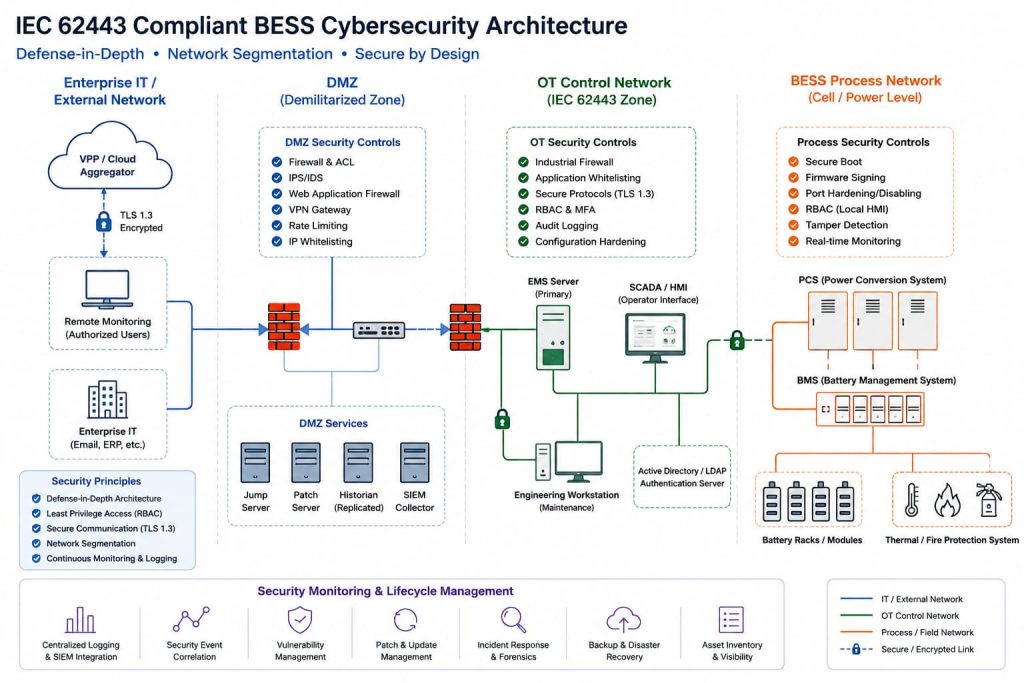

Detailed schematic of the MegSolid BESS cybersecurity architecture, dividing the system into Enterprise IT, DMZ, OT Control, and Process networks, detailing industrial firewall placements, TLS 1.3 encryption, and security monitoring lifecycle management.

Common FAT Shortcuts That EPC Contractors Should Reject

A well-organized factory tour does not necessarily indicate a successful FAT. Several shortcuts should immediately raise concerns.

Avoid manufacturers who rely on pre-recorded demonstration videos instead of testing the actual equipment, skip full-load or grid simulation tests, or verify batteries, PCS, and EMS separately rather than as one integrated system. Another warning sign is when engineers are only shown HMI screens without witnessing the protection logic and communication response under fault conditions.

These shortcuts often save factory time but shift commissioning risks directly to the project site.

Why Factory-Integrated Manufacturers Deliver More Reliable FAT Results

The quality of a Factory Acceptance Test ultimately depends on the manufacturer's engineering capability.

Manufacturers that design and integrate the battery system, PCS, EMS, and control software within the same engineering process are generally able to provide more consistent FAT procedures, standardized documentation, and faster issue resolution than suppliers assembling products from multiple sources.

MegSolid provides integrated commercial and industrial Battery Energy Storage Systems, including outdoor cabinet solutions, liquid-cooled systems, PCS, and containerized BESS platforms. Technical parameters are maintained using model-specific engineering documentation rather than generic marketing specifications.

For larger projects, EPC contractors can evaluate solutions such as Containerized Battery Energy Storage Systems, Outdoor Cabinet Energy Storage Systems, and the Energy Storage Application Cases to understand how integrated factory validation supports successful project delivery.

FAQ

EPC contractors should evaluate more than product specifications. A professional supplier should provide a documented Factory Acceptance Test (FAT), complete engineering drawings, live PCS and EMS functional verification, communication testing, safety system validation, and traceable FAT reports before shipment. These engineering deliverables reduce commissioning risks and improve long-term system reliability.

A comprehensive FAT checklist should cover engineering documentation review, PCS performance verification, BMS and EMS functional testing, grid simulation, thermal management validation, fire protection system checks, communication verification, emergency shutdown testing, alarm logic confirmation, and final FAT documentation approval before shipment.

Integrated manufacturers design and validate the battery system, PCS, EMS, and control software as a complete solution. This allows them to perform standardized system-level FAT procedures, verify subsystem compatibility, maintain engineering traceability, and resolve integration issues before delivery, reducing project risks for EPC contractors.

A Battery Energy Storage System Factory Acceptance Test (FAT) is a structured engineering verification conducted before shipment. It confirms that the battery system, PCS, BMS, EMS, and safety systems operate together according to the approved project specifications, reducing commissioning risks and minimizing costly on-site corrections.

FAT allows EPC contractors to identify design inconsistencies, communication issues, software configuration errors, and protection logic problems before equipment reaches the project site. Resolving these issues at the factory is significantly faster and less expensive than correcting them during commissioning.

Factory Acceptance Testing (FAT) is performed at the manufacturer's facility before shipment, while Site Acceptance Testing (SAT) takes place after installation. FAT verifies manufacturing quality and system integration, whereas SAT confirms correct installation, grid connection, and operational performance under actual site conditions.

A complete FAT should verify all critical subsystems rather than testing individual components separately. These typically include the battery system, PCS, BMS, EMS, communication network, thermal management system, fire protection system, HMI, and protection logic.

The duration depends on system size and project complexity. Most commercial and industrial BESS projects require one to three days, while utility-scale containerized systems may require additional time for comprehensive functional and performance verification.

Yes. Although remote FAT sessions have become more common, witnessing the FAT on-site allows engineers to inspect build quality, verify documentation, observe live testing, ask technical questions, and ensure that the actual equipment—not a demonstration unit—is being tested.

EPC teams should review the approved FAT report, single-line diagram, general arrangement drawings, final BOM, software versions, calibration records, communication test results, protection settings, and any corrective action reports before signing the shipment release.

The most frequently identified issues include PCS configuration errors, EMS logic conflicts, communication failures, incorrect protection settings, abnormal alarm responses, sensor calibration deviations, and inconsistencies between engineering documentation and the assembled system.

No. FAT verifies factory assembly and system integration before shipment, while commissioning and SAT confirm that the system performs correctly after transportation, installation, and grid connection. Both stages are essential to reduce project risk.

A reliable manufacturer should provide standardized FAT procedures, complete engineering documentation, live functional demonstrations, traceable test records, and opportunities for customer witness testing. Suppliers that only provide presentation slides or recorded videos without live verification should be evaluated carefully.

MegSolid (Hong Kong) Limited focuses on the R&D, design and supply of high-performance energy storage systems. With ten years of technical accumulation, we offer customized outdoor cabinet ESS, residential inverters and portable power solutions for global clients.
WhatsApp/Wechat: +852 59811073

Get Your MegSolid Energy Storage Solution in 24 Hours

Direct from a Solid-State Battery Manufacturer. Receive a customized ESS proposal, ROI analysis, and system recommendation from our engineering team.

What You'll Receive

Trusted Worldwide:

UL, IEC, UN38.3,China Classification Society,GB36276-2023,RoHS
