How to Size BESS for Irish Data Centres Under CRU Grid Rules

A data centre developer in Ireland can no longer treat battery storage as an optional sustainability feature added after the grid connection is designed.

For new projects covered by Ireland’s updated connection policy, dispatchable generation and/or storage forms part of the connection strategy itself.

The procurement problem is not simply:

How many megawatt-hours of batteries should the data centre install?

The project must first establish:

The MegSolid equipment configuration should only be selected after these regulatory and operating boundaries have been converted into installed MW, required MWh and an approved connection architecture.

Why Ireland’s New Connection Policy Changes BESS Procurement

The Commission for Regulation of Utilities published its final Large Energy Users connection-policy decision on 12 December 2025.

The policy requires new data centres to provide generation and/or storage, onsite or locally proximate, to match the requested maximum import demand. The associated asset must participate in the wholesale electricity market. Projects must also meet at least 80% of annual electricity demand with additional renewable generation located in the Republic of Ireland, subject to a six-year glide path. See the CRU data centre connection-policy decision.

EirGrid implemented the decision through DCCOPP Version 3 on 20 May 2026. A qualifying application now connects three related workstreams:

The demand project cannot be assessed as an isolated building load while the nominated energy assets remain undefined.

Determine Which MIC Category Applies

Maximum Import Capacity, or MIC, is the maximum capacity the customer proposes to draw from the electricity system.

It is a connection value, not the data centre’s average IT load and not necessarily the same as its generator or BESS MW rating.

Requested MICCurrent EirGrid Requirement
Below 1MVADCCOPP Version 3 does not apply, but locational constraints may still be assessed
1MVA to below 10MVAAutoproducer unit sufficient to cover MIC after de-rating
10MVA or aboveNew, separately connected dispatchable onsite or proximate generation and/or storage sufficient to cover MIC after de-rating

For 1MVA to below 10MVA, the autoproducer must participate in the Single Electricity Market and remain operational for the connection duration.

For projects at or above 10MVA, the nominated asset must be separately connected and metered, participate in the SEM as a standalone market unit and remain available throughout the connection period.

The network application route also matters. EirGrid directs facilities below 20MVA at one location to ESB Networks, while applications of 20MVA or above are normally submitted to EirGrid. This routing threshold should not be confused with the 1MVA and 10MVA policy categories. See the EirGrid demand-connections page.

What Does Matching 100% of MIC Mean?

The requirement is based on de-rated capacity, not equipment nameplate capacity.

A project with a 30MVA MIC cannot order a 30MW BESS and assume compliance.

EirGrid requires:

De-rated Nominated Capacity ≥ Ramped or Enduring MIC

The installed capacity must therefore be calculated using the current Capacity Remuneration Mechanism de-rating factor for the selected technology class.

EirGrid provides an indicative example in which a 30MVA data centre requires approximately 34.8MW of dispatchable generation before renewable contribution is recognised. That example illustrates the effect of de-rating, but it is not a universal battery-storage ratio. A BESS must use the prevailing factor applicable to its storage class and duration.

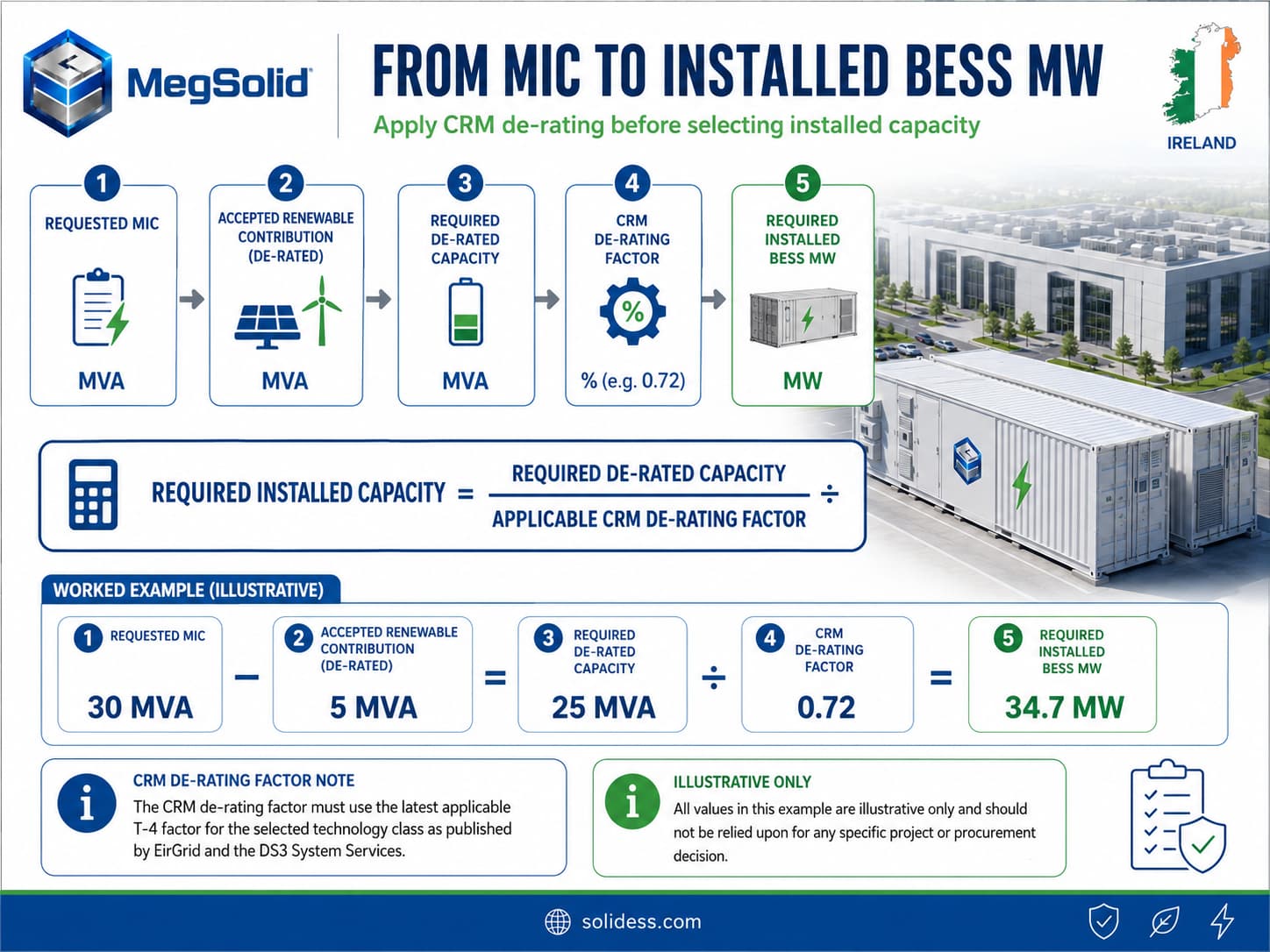

Apply CRM De-Rating Before Selecting Installed MW

The preliminary compliance equation is:

Required Installed Capacity = Required De-rated Capacity ÷ Applicable CRM De-rating Factor

Where:

The applicable factor must come from the latest relevant SEM Capacity Market T-4 auction information. It should not be copied from an old project, another battery duration or a gas-generation example.

EirGrid states that storage used to support a data centre must be sized using the most recent technology-specific T-4 de-rating factors. It may also reassess capacity where actual unit availability persistently underperforms the applicable technology benchmark.

The RFQ should therefore state:

CRU Policy Does Not Define One Universal Battery Duration

Matching MIC determines the required capacity contribution. It does not by itself define how many hours the battery must discharge.

Battery duration depends on:

Consider an illustrative project whose approved operating study requires 10MW of sustained battery discharge.

Required DurationAC Energy Delivered
1 hour10MWh
2 hours20MWh
4 hours40MWh

Using an illustrative 80% usable SOC window and 90% discharge-path factor:

Required DurationPreliminary Nominal Capacity
1 hour13.9MWh
2 hours27.8MWh
4 hours55.6MWh

These figures explain the electrical relationship. They are not CRU-mandated storage durations.

Separate Grid-Compliance BESS From UPS Backup

A data centre normally contains several distinct power responsibilities.

SystemPrimary Responsibility
IT UPSNo-break continuity for defined critical loads
Standby generatorsLonger-duration site resilience
Nominated BESSGrid-visible dispatchable capacity and market participation
Renewable assetsAnnual renewable-energy obligation
Campus EMSCoordination of import, export, reserve and recharge
BMSBattery safety, SOC, SOH and operating limits

A grid-compliance BESS should not automatically replace the existing UPS.

UPS architecture is selected from allowable interruption, redundancy level, IT topology and battery autonomy. The nominated storage asset is selected from MIC, market availability, de-rating and dispatch requirements.

The same physical battery might support both roles only where the switchgear, market rules, reserve policy and failure analysis prove that neither responsibility compromises the other.

Review the data centre UPS and critical-power engineering guide before combining the two functions.

Check Whether BESS Recharging Creates a New Grid Constraint

A large BESS can reduce an adequacy problem during discharge and create a network problem during recharge.

EirGrid’s technical assessment provides a direct example: if a 100MW data centre uses a 300MW storage facility, total local demand could reach 400MW when the data centre remains operational while the storage recharges. If that condition overloads equipment, the project may be classified as being in a constrained area. See the EirGrid Data Centre Technical Assessment.

The project must calculate:

Maximum Area Demand = Data Centre Demand + BESS Recharge Power + Other Coincident Demand

It must also determine:

Recharge Time = Energy Required From the Grid ÷ Permitted Recharge Power

Assume a BESS must restore 40MWh of usable energy.

With a 90% charging-path factor:

Grid Energy Required = 40MWh ÷ 0.90 = 44.4MWh

If the connection study permits only 8MW of recharge power:

Minimum Recharge Time = 44.4MWh ÷ 8MW = 5.56 hours

A four-hour recovery window would therefore be insufficient, regardless of battery nameplate capacity.

Align Storage Delivery With the Campus Ramp-Up Plan

Data centre campuses are normally energised in phases.

The nominated capacity must arrive with the corresponding MIC. EirGrid states that the data centre cannot become operational or ramp beyond the level supported by delivered de-rated capacity.

Campus PhaseIllustrative IT LoadIllustrative MICStorage Procurement Action
Phase 18MW10MVAInstall initial PCS and battery blocks
Phase 216MW20MVAAdd parallel PCS and energy containers
Phase 325MW30MVAComplete medium-voltage pooled system

A phased architecture can prevent unused capacity from sitting idle during early construction.

However, the first-phase design must reserve:

The comparison between distributed cabinets and centralised systems is covered in the modular cabinets versus containerized ESS guide.

Engineering flowchart showing how to calculate required installed BESS MW from a requested MIC by applying CRM de-rating factors.

Onsite vs. Proximate Storage

For larger projects, the nominated generation or storage may be onsite or proximate.

The decision affects more than land availability.

IssueOnsite BESSProximate BESS
Electrical boundaryWithin or adjacent to campusSeparate energy site
Land requirementCompetes with data halls and utilitiesRequires separate site control
Cable and network dependencyShorter internal connectionDepends on external grid path
MeteringSeparate metering still requiredSeparate market and connection interfaces
Fire and access controlIntegrated with campus planningSeparate emergency-response plan
Market participationStandalone unitStandalone unit
Delivery programmeLinked to campus constructionLinked to generation connection process

EirGrid requires the nominated asset to be separately connected and metered from the data centre connection, with mandatory SEM participation for projects at or above 10MVA.

Market Participation and Emergency SOC Cannot Share Unlimited Energy

A battery assigned to SEM dispatch cannot simultaneously promise that its entire capacity remains reserved for a data centre outage.

The operating specification should define separate energy responsibilities:

SOC ResponsibilityPurpose
Market operating windowSEM and capacity obligations
Grid-support reserveApproved system response
Data centre emergency reserveProject-specific resilience duty
Degradation marginCapacity fade across the contract period
Maintenance and fault marginUnplanned module or PCS unavailability

Percentages should not be inserted into the article or RFQ until the market duty and resilience study are complete.

The control philosophy should be documented through the BMS and EMS communication architecture, including:

Ireland Data Centre BESS Sizing Example

Assume a new campus has:

InputIllustrative Value
Phase 1 MIC10MVA
Phase 2 MIC20MVA
Phase 3 MIC30MVA
Project-selected dispatch duration2 hours
Usable SOC window80%
Discharge-path factor90%
Maximum permitted recharge power10MW

The project must first obtain the current storage de-rating factor and calculate the installed MW needed at each phase.

Assume the final approved study ultimately specifies 30MW of installed discharge capability for illustration.

Required AC Energy = 30MW × 2h = 60MWh

Preliminary Nominal Capacity = 60MWh ÷ 0.80 ÷ 0.90 ≈ 83.3MWh

To restore 60MWh usable energy with a 90% charging-path factor:

Required Grid Energy = 60MWh ÷ 0.90 ≈ 66.7MWh

At a 10MW recharge limit:

Recharge Time ≈ 6.67 hours

The project is not design-ready until the operating model confirms that such a recovery window is available without breaching MIC or creating a constrained-area condition.

Fault Ride-Through and Dynamic Models

EirGrid identifies data centre fault ride-through as a significant power-system challenge.

During transmission faults, data centres may rapidly reduce grid consumption and move to temporary backup supplies. The resulting sudden demand change can affect system stability. EirGrid therefore requires dynamic models showing how the facility responds to voltage and frequency disturbances, together with normal operating profiles and details of proposed mitigation equipment.

The study must define how the BESS behaves during:

Grid-forming or grid-following operation should be selected from the approved system study, not used as a general marketing claim.

Preliminary MegSolid Product Direction

Verified Project RequirementPreliminary MegSolid Direction
Custom 30–500kW PCS blocksMEGA PCS
500kW/approximately 1MWh blockESSC 500kW/1.0752MWh
1MW/approximately 2MWh blockESSC 1MW/2.1504MWh
2.7MW/approximately 5MWh block5000INTL
10–30MW campusMultiple containerized blocks with central EMS
50MWh-plus requirementPhased medium-voltage pooled architecture

The MEGA energy storage PCS range covers 30–500kW models with built-in isolation transformers. Its IP21 enclosure requires installation inside an appropriate room or container.

The ESSC containerized energy storage system includes 500kW/1.0752MWh and 1MW/2.1504MWh air-cooled LFP configurations.

The 5000INTL containerized BESS is rated at 2.7MW/5.0159MWh and uses liquid cooling. The current public product data does not explicitly classify its battery chemistry, so the model must not be described as LFP or hybrid solid-state without a controlled project document.

These blocks are product directions, not confirmation of Irish policy compliance. The final design must verify:

Application Data Required by EirGrid

DCCOPP Version 3 requires the application package to include the requested MIC, energisation timeline, ramping details, dynamic models, fault ride-through information and nominated generation and renewable details.

A BESS supplier should receive at least:

Data Required to Match BESS With the Requested MIC

Send the phased MIC, data centre load, required storage duty, permitted recharge power and electrical single-line diagram.

The returned configuration should identify:

FAT and SAT for an Irish Data Centre BESS

A standard battery charge-discharge demonstration is insufficient.

The FAT should verify:

The SAT should verify the complete connection boundary, including the point-of-connection meter, medium-voltage switchgear, transformer, EMS, SCADA, UPS, generators and data centre power-management system.

Use the BESS Factory Acceptance Testing guide to convert the approved operating sequence into witnessed pass/fail criteria.

Safety documents should be checked through the UL 9540A and IEC 62619 compliance guide. Product-level certificates do not replace Irish planning, electrical and fire approval for the complete installation.

Final Procurement Decision

An Irish data centre BESS should not be purchased from MIC alone.

The project must prove:

FAQ

It needs sufficient de-rated generation and/or storage capacity to cover the applicable MIC. Installed BESS MW may therefore exceed MIC, depending on the current CRM de-rating factor.

No. The policy establishes a de-rated capacity requirement but does not impose one universal storage duration for every project.

They should not be assumed to qualify. The nominated asset must satisfy connection, metering, market, additionality, availability and de-rating requirements.

The policy allows dispatchable generation or storage to be onsite or locally proximate, subject to the connection and application requirements.

For the applicable categories, the nominated asset must participate in the Single Electricity Market under the stated connection structure.

An accepted renewable contribution may be credited on a de-rated basis, up to the policy limit. Annual renewable compliance and capacity contribution are separate calculations.

The battery may add substantial demand while recharging, potentially overloading local equipment or creating a constrained-area condition.

Potentially, but the project must reserve sufficient SOC and prove that market dispatch cannot compromise the approved emergency duty.

Not necessarily. Storage can be phased with MIC growth, provided the electrical and civil infrastructure allows later expansion.

Provide phased MIC, applicable de-rating factor, required duration, recharge limit, UPS and generator architecture, single-line diagram and commissioning programme.

Calculate installed MW from MIC and the current CRM de-rating factor, then calculate MWh from the required dispatch duration, SOC window, losses and recharge constraints.

Qualifying new data centres must provide dispatchable onsite or proximate generation and/or storage sufficient to cover MIC after de-rating, together with additional renewable-energy commitments.

It can form part of the required nominated capacity, but the project must also pass locational, system-stability, renewable, market and connection assessments.

MegSolid (Hong Kong) Limited focuses on the R&D, design and supply of high-performance energy storage systems. With ten years of technical accumulation, we offer customized outdoor cabinet ESS, residential inverters and portable power solutions for global clients.
