A Polish storage project can satisfy a programme threshold and still purchase the wrong battery configuration.
The critical distinction is whether “4MWh” means installed nameplate capacity or four megawatt-hours delivered at the grid connection point.
After usable SOC, PCS losses, transformer losses, auxiliary consumption and degradation are considered, those two specifications produce different equipment quantities.
MegSolid therefore starts a 2MW/4MWh Poland BESS project by defining the point-of-interconnection guarantee before selecting the battery containers.

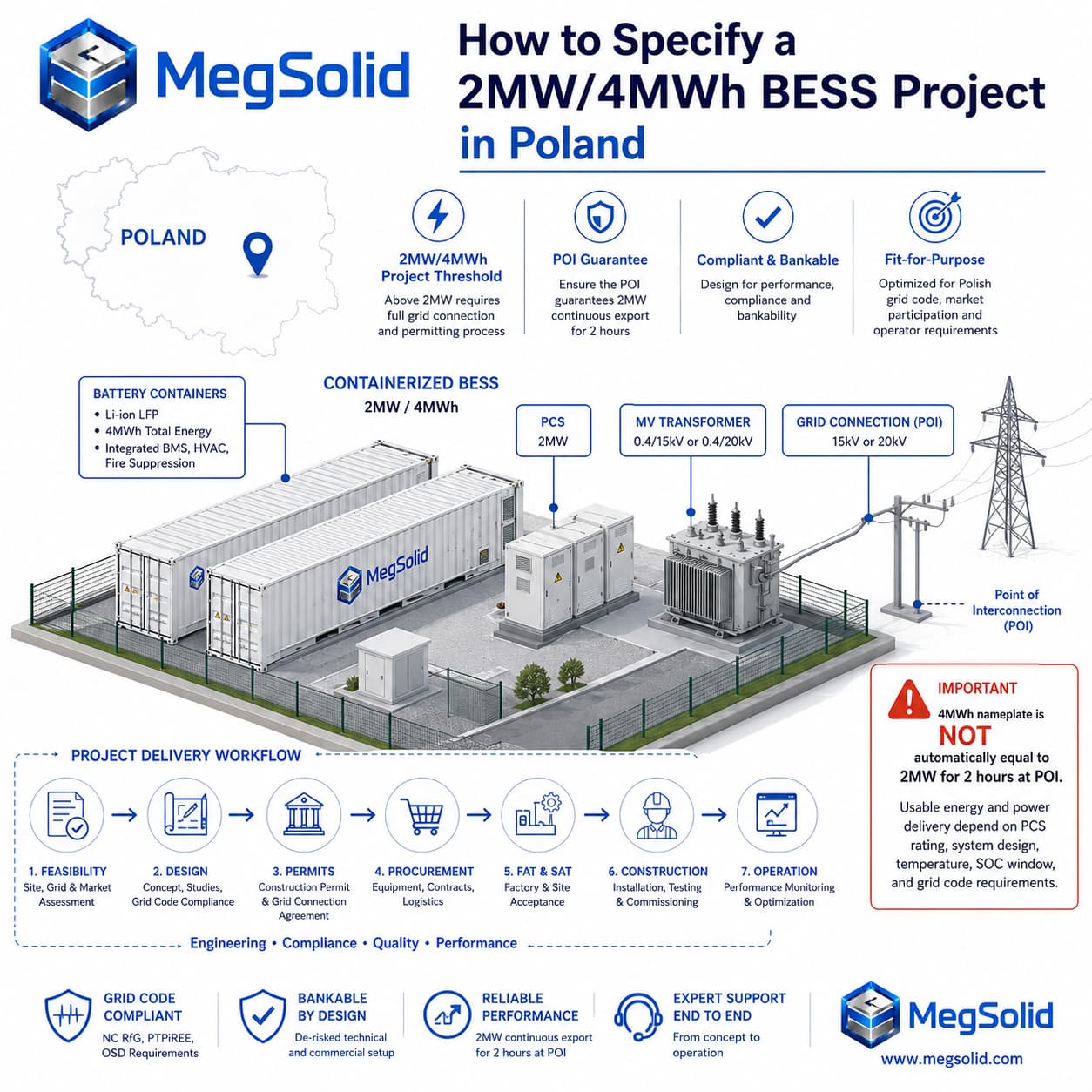

Why 2MW/4MWh Is Not a Complete Specification
Poland’s NFOŚiGW programme supports storage installations with at least 2MW of power and 4MWh of capacity.
Its eligible scope includes battery containers, inverters, transformers, fire protection, HVAC, protection systems, testing and acceptance.
These values are programme thresholds, not a universal two-hour performance guarantee. See the official NFOŚiGW storage programme.
Before requesting a quotation, define:
- Installed power: Total PCS nameplate MW.
- Nameplate energy: Total battery MWh before operating restrictions.
- Usable energy: Energy available inside the approved SOC window.
- POI energy: AC energy delivered after system losses.
- End-of-life energy: Guaranteed capacity after contractual degradation.
An RFQ that only states “2MW/4MWh” leaves these boundaries unresolved. Review the broader commercial energy storage procurement framework before assigning responsibility between the battery, PCS, EMS and EPC suppliers.
Follow the Polish Approval Path Before Freezing the Layout
A 2MW project falls within Poland’s investment route for storage above 50kW and not exceeding 10MW.
The official process covers spatial planning, grid conditions, construction procedures, completion notification and entry in the storage register.
Outdoor storage above 2,000kWh requires a construction permit.
Projects covering more than one hectare—or 0.5 hectare in protected areas—also enter the environmental-decision route. See the official Polish storage investment process.
The practical project sequence is:
Site control → planning basis → grid conditions → permit layout → final BESS specification → FAT → delivery → energisation → registration
The container quantity should be established before the permit layout is finalised because it affects fire access, equipment spacing, transformer location, cable routes and expansion space.
Compare modular cabinets versus containerized ESS before completing the site plan.
Secure Grid Conditions Before Ordering Equipment
The connection application must define power in both directions. Approval to discharge 2MW does not automatically permit the BESS to charge at 2MW.
The technical schedule should state:
- Maximum charging and discharging power.
- POI voltage and connection capacity.
- Active- and reactive-power requirements.
- Ramp rate and protection behaviour.
- Transformer and auxiliary losses.
- Metering and SCADA interfaces.
- Fallback limits after communication failure.
Poland’s April 2026 connection reform shortened the validity of many new connection conditions from two years to one year, extended cable pooling to storage and introduced construction-permit milestones for projects connected above 1kV. See the PSE connection-rule notice.
A 2MW BESS is normally classified as Type B. TAURON lists the thresholds as 0.2MW for Type B, 10MW for Type C and 75MW for Type D.
The project should follow the requirements of its actual OSD rather than copying the Type D commissioning procedure.
Calculate Guaranteed AC Energy at the POI
Assume the contract requires the plant to deliver 2MW for two continuous hours:
Required AC energy = 2MW × 2h = 4MWh
Using illustrative preliminary assumptions:
Usable SOC window = 80%
Discharge-path factor = 90%
The required battery nameplate capacity becomes:
4MWh ÷ 0.80 ÷ 0.90 ≈ 5.56MWh
This calculation explains why a 4MWh nameplate system may fail a four-megawatt-hour POI test.
The final model must replace the illustrative values with verified:
- PCS efficiency
- Transformer losses
- Cooling and auxiliary consumption
- Minimum and maximum SOC
- Site temperature
- Battery degradation
- End-of-life guarantee
- Module or PCS availability
The contract should also state whether the two-hour guarantee applies only at commissioning or throughout the warranty period.
Compare MegSolid Configurations for a 2MW Project
| Preliminary configuration | Nameplate rating | Procurement interpretation |
|---|---|---|
| 2 × ESSC 1MW/2.1504MWh | 2MW/4.3008MWh | Meets the programme nameplate threshold; two-hour POI delivery still requires verification |
| 3 × ESSC 1MW/2.1504MWh | 3MW/6.4512MWh | Provides additional energy and redundancy; EMS can limit POI output to 2MW |
| 1 × 5000INTL | 2.7MW/5.0159MWh | Compact 5MWh-class block, but below the illustrative 5.56MWh calculation |
| Engineered 2MW PCS system | 2MW/project-specific MWh | Allows battery capacity to follow the POI and end-of-life guarantee |
The ESSC containerized BESS includes 500kW/1.0752MWh and 1MW/2.1504MWh air-cooled LFP configurations.
The MEGA PCS range provides 30–500kW building blocks for custom architectures.
The 5000INTL is rated at 2.7MW/5.0159MWh with liquid cooling. Its battery chemistry should be confirmed through controlled project documentation and must not be inferred from the model code.
Review the 5MWh BESS engineering architecture before choosing between a single large block and multiple smaller containers.
Define the Complete POI and EMS Scope
A battery-container quotation does not automatically guarantee plant performance at the grid meter.
The responsibility matrix must cover:
- Battery racks and BMS
- PCS and plant controller
- MV transformer and switchgear
- POI meter and export controller
- SCADA and OSD communication
- Protection, earthing and auxiliary supply
- Harmonic and reactive-power performance
For cable-pooled renewable projects, the EMS must keep the combined renewable and BESS output within the approved connection limit.
It must also define charging priority, renewable curtailment, meter-loss fallback and communication timeouts.
Use the BMS and EMS communication architecture to prepare the project signal matrix.
Convert the Grid Specification Into FAT and SAT
A partial-power factory demonstration is insufficient for a 2MW plant.
The FAT should verify:
- 2MW active-power operation.
- Maximum permitted charging power.
- Reactive-power commands.
- POI limit control using a meter simulator.
- Low-SOC power reduction.
- Loss of one PCS block.
- EMS, meter and SCADA communication failure.
- Emergency stop, restart and event recording.
SAT should repeat the critical control tests through the installed transformer, MV switchgear, POI meter and OSD interface.
Use the BESS Factory Acceptance Testing guide to convert the approved control sequence into witnessed pass/fail criteria.
Product safety documents can be screened through the UL 9540A and IEC 62619 compliance guide, but these documents do not replace Polish construction and fire approval.
Data Required for a Firm Poland BESS Quotation
Submit the Grid Conditions and Site Plan
Provide:
- Project location and available site area.
- Planning and construction-permit status.
- Grid-condition status and relevant OSD.
- Maximum charging and discharging power.
- Whether 4MWh means nameplate or guaranteed POI delivery.
- Required duration and end-of-life capacity.
- Connection voltage and single-line diagram.
- Transformer and switchgear scope.
- Cable-pooling requirements.
- FAT, delivery and energisation dates.
The engineering response should identify container quantity, PCS rating, nominal and usable MWh, MV interface, EMS responsibilities, acceptance tests and missing documents.
Final Procurement Recommendation
Two ESSC 1MW/2.1504MWh containers can provide a 2MW/4.3008MWh nameplate system.
That configuration should not be sold as a guaranteed two-hour POI solution until the usable-energy, loss and degradation calculations pass.
A quotation is technically ready only when:
- The planning and permit route is confirmed.
- Grid conditions define charging and discharging limits.
- POI energy is guaranteed after losses.
- EMS responsibility is documented.
- FAT and SAT criteria are agreed before production.
FAQ
Q1: Is 2MW/4MWh mandatory for every Polish BESS?
No. It is the minimum size used by a specific NFOŚiGW support programme.
Q2: Does 4MWh nameplate guarantee 2MW for two hours?
No. Usable SOC, conversion losses, auxiliary consumption and degradation reduce POI energy.
Q3: Does an outdoor 4MWh system require a construction permit?
Yes. Poland’s official route requires a construction permit above 2,000kWh outdoors.
Q4: Is a 2MW BESS Type B?
Yes. The published thresholds place 0.2MW to below 10MW in Type B.
Q5: Does a 2MW project require a storage licence?
Normally no. Storage above 50kW and not exceeding 10MW requires register entry; licensing applies above 10MW.
Q6: Can charging and discharging power differ?
Yes. Both limits must be defined in the connection conditions and EMS specification.
Q7: Can BESS share a renewable project connection?
Potentially. The 2026 cable-pooling provisions include storage, subject to the approved connection structure.
Q8: Which MegSolid configuration reaches the programme threshold?
Two ESSC 1MW/2.1504MWh units provide 2MW/4.3008MWh nameplate.
Q9: What must FAT prove?
It should prove power commands, POI limits, low-SOC behaviour, fault responses, protection and data recording.
Q10: What is required for a firm quotation?
Grid conditions, site plan, POI guarantee, duration, connection voltage, single-line diagram and project schedule.
Q11: How do you specify a 2MW/4MWh BESS in Poland?
Confirm the permit and grid route first, then define guaranteed POI energy, losses, EMS scope and acceptance tests.
Q12: What approvals normally apply to a Polish 2MW BESS?
The route normally includes spatial planning, grid conditions, a construction permit, completion notification and storage-register entry.
Q13: Which container configuration is suitable?
Two 1MW/2.1504MWh containers meet the nameplate threshold. A guaranteed two-hour service may require additional nominal capacity.
