300kW / 1MWh BESS in Nigeria: Sizing and Quote Requirements

A 300kW / 1MWh BESS provides 3.33 hours at full rated power before SOC limits, conversion losses, temperature derating and battery aging are applied. A Nigerian C&I project therefore needs a usable-energy calculation before the EPC fixes the equipment quantity.

Before requesting quotes, define the PCC voltage, transformer rating, load profile, generator and PV interfaces, export rule, backup reserve and local EPC responsibilities. These inputs allow suppliers to quote the same electrical duty and delivery boundary.

Project context used for this article: an anonymous Nigerian C&I EPC inquiry for a grid-connected, outdoor, container-style energy-storage project serving large industrial loads. The inquiry named 300kW and 1,000kWh, while the electrical schedule, load profile, location elevation and final field scope remained open for engineering confirmation.

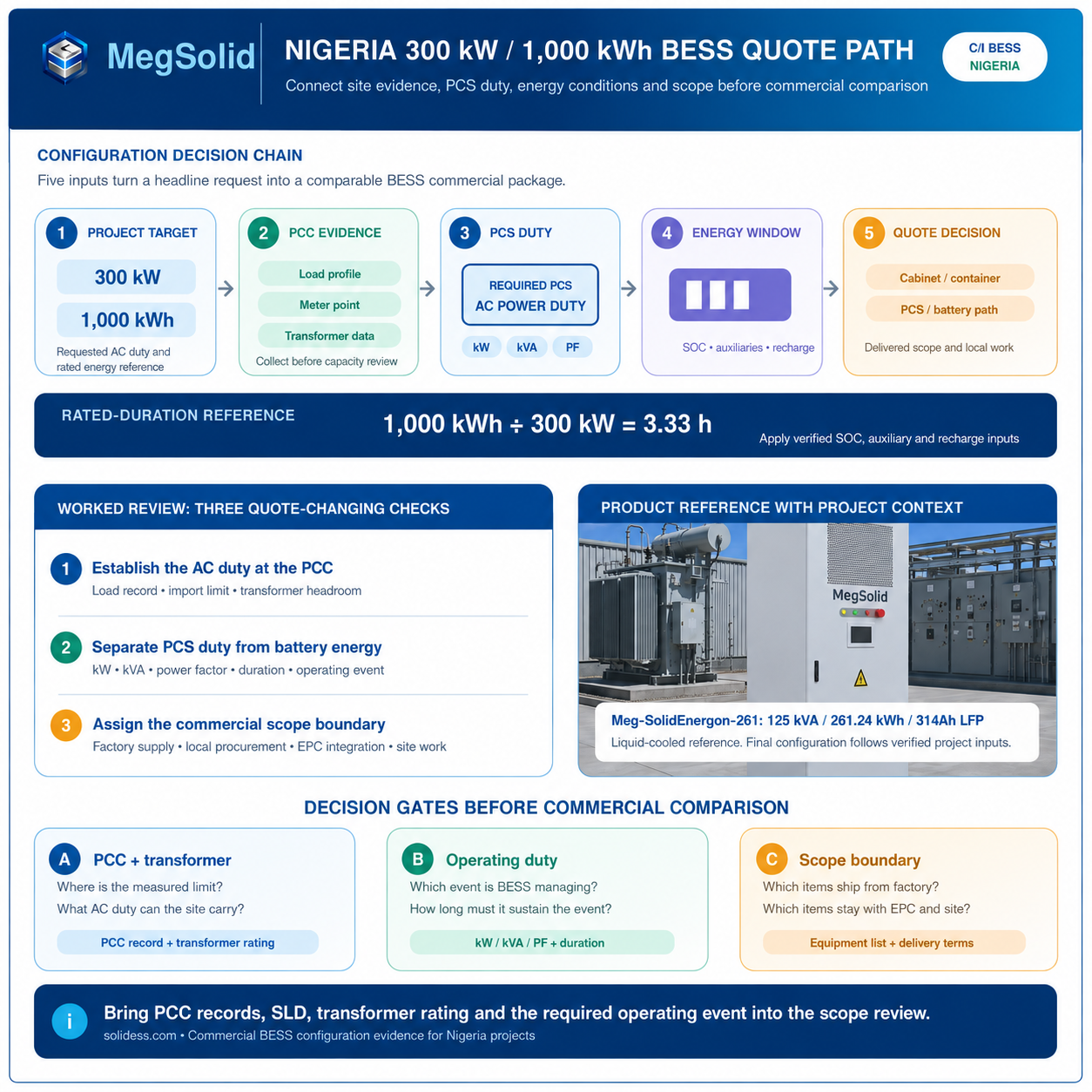

MegSolid 261.24kWh 125kVA liquid-cooled C and I energy storage cabinet in a bright electrical compound, alongside a five-step Nigeria 300kW 1000kWh BESS configuration and quote decision flow

How to Size a 300kW / 1MWh BESS in Nigeria

The commercial question is whether the configuration can support the required electrical event at the actual site.

For a 300kW load event, the nominal 1,000kWh ÷ 300kW quotient equals 3.33 hours. That arithmetic is only an opening reference. The engineered duration requires the agreed state-of-charge window, conversion losses, ambient derating, battery aging allowance, auxiliary consumption and load shape.

Data that turns a capacity request into an engineering basis

The EPC can collect the following items before a manufacturer prepares a controlled proposal.

Project inputEvidence to requestDecision supported
Load profileAt least 15-minute interval data, peak events and operating calendarAC power duty and required duration
PCC and transformerSingle-line diagram, transformer nameplate and protection settingsConnection voltage, current and protection scope
Grid conditionOutage history, voltage quality record and utility requirementsGrid-following, backup or microgrid control path
Site environmentOutdoor layout, access path, elevation, ambient range and drainage planEnclosure, cooling and civil-work review
Existing sourcesGenerator ratings, controller details and local PV arrangementSource coordination and EMS interfaces
Commercial objectiveFuel displacement, import limit, resilience, tariff timing or process continuityDispatch logic and financial model

Why this changes the quotation: a battery nameplate without these inputs leaves the PCS rating, enclosure count, cables, switchgear, transformer work and controls scope open to interpretation.

Keep AC Power, Apparent Power and Battery Energy Separate

The proposal must show the relationship between kW, kVA and kWh in plain project terms.

MegSolid’s current energy storage inverter portfolio includes the MEGA0030TS–MEGA0500TS PCS range. Published model ratings cover 30kW through 500kW, with 400V rated AC voltage, an integrated isolation transformer, grid-current THD below 3%, adjustable power factor and RS485/CAN plus RS485/TCP-IP communications. A 300kW request therefore needs a stated PCS topology, selected model combination and interface drawing rather than a generic inverter line item.

Configuration questionScope evidence that answers it
Can 300kW be delivered at the duty power factor?PCS schedule, kW/kVA declaration and AC current calculation
Can 1,000kWh support the duty interval?Rated energy, operating SOC window, aging allowance and duty-cycle calculation
Can the system recharge between events?Charge-power limit, source availability and EMS schedule
Can the PCC accept the dispatch?Single-line diagram, protection settings and utility/EPC review
Can the site maintain the intended output?Ambient assumptions, enclosure arrangement and auxiliary-power calculation

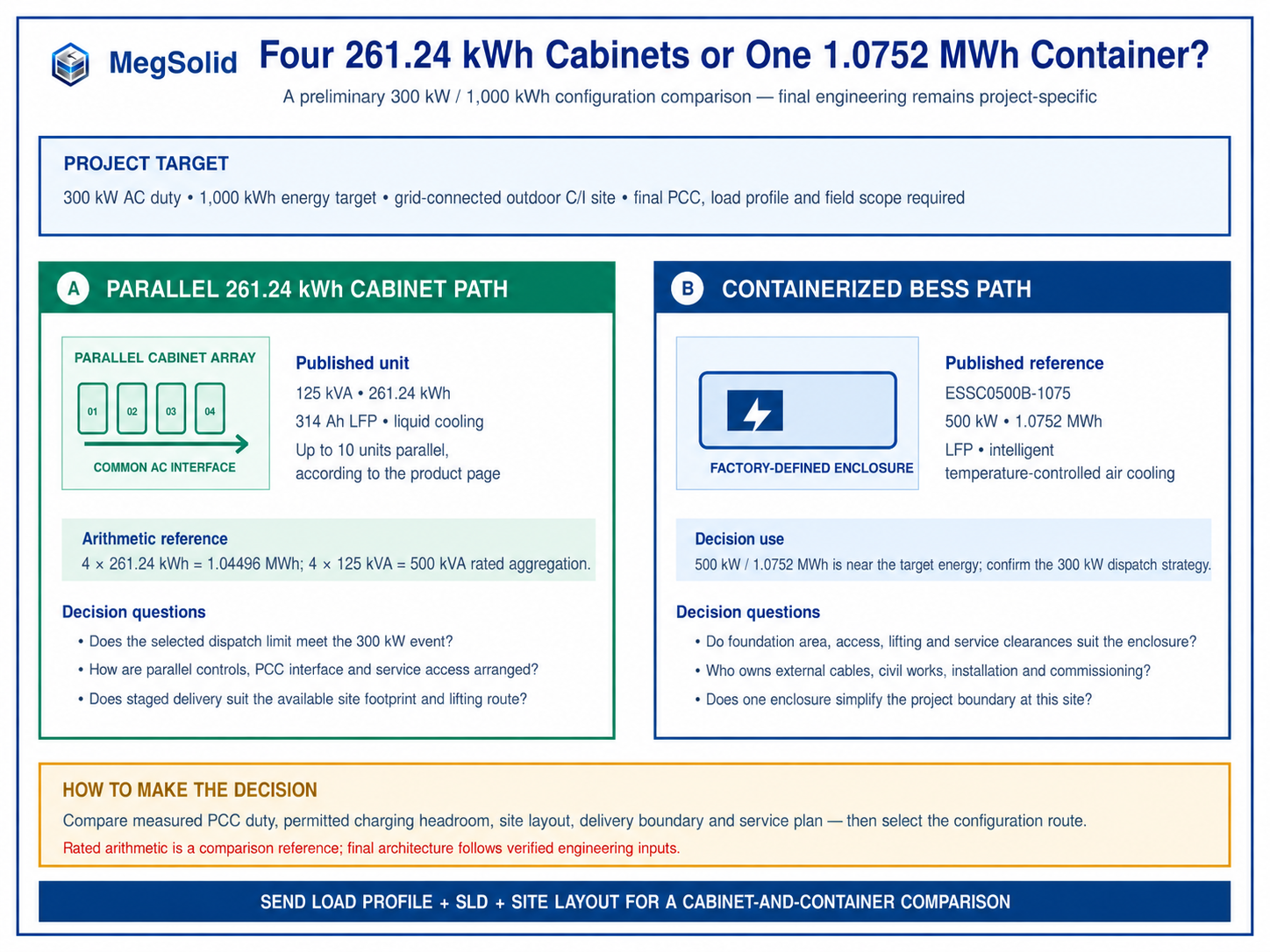

Technical comparison for a Nigeria 300kW 1000kWh commercial BESS project: four 261.24kWh 125kVA liquid-cooled cabinets and a 500kW 1.0752MWh containerized BESS reference, with site decision checks

300kW / 1MWh BESS Configuration Options

MegSolid publishes several C&I and containerized product families that can inform an early engineering discussion.

Published product pathVerified public ratingRole in a 300kW/1,000kWh reviewEngineering confirmation required
ESSA0100B-0215 outdoor cabinet100kW AC; 215.04kWh; LFP; intelligent air coolingArithmetic reference: three published nameplates equal 300kW AC and 645.12kWh rated energyDuration, cabinet topology, controls, field cabling and site conditions
Meg-SolidEnergon-261kWh liquid-cooled C&I system125kVA; 261.24kWh; 314Ah LFP; liquid coolingFour units total 500kVA and 1.04496MWh rated energy before operating limitsSelected kW dispatch limit, power factor, parallel architecture, PCC interface and installation boundary
MEGA TS PCS30–500kW rated output by model; isolation transformerCreates a defined AC conversion path for engineered battery architecturesSelected PCS quantity, battery compatibility, switchgear, protection and BOP
ESSC0500B-1075 containerized BESS500kW; 1.0752MWh; LFP; intelligent temperature-controlled air coolingPublished container reference near the stated energy scale300kW dispatch strategy, layout, import/export control, civil works and delivery scope

The table is a comparison tool, rather than a promise that any row fits the project unchanged. Each final solution needs a controlled datasheet, single-line diagram, BOM, thermal boundary and applicable certificate scope.

For cabinet-versus-container deployment decisions, review modular cabinets versus containerized ESS deployment. A modular approach can support staged delivery and service segmentation. A container approach can concentrate more equipment within one factory-defined enclosure. Site lifting route, foundation area, electrical segregation, access clearance and service plan decide which route serves the project.

PCC Metering and Grid-Connection Inputs for the Nigerian Site

The bill, electrical point and control boundary must describe the same project event.

For projects where grid stability and backup power interact with generator operation, the Nigerian operating questions in PV-diesel-BESS microgrid engineering for Nigeria help the EPC define source priority and control hand-off. MegSolid supplies storage equipment and controls interfaces; PV modules and local PV balance-of-system supply belong in the local project package.

A dispatch statement that procurement and engineering can share

Use a short operational statement in the bid package.

Operating statement: During the defined industrial operating period, maintain PCC import within the agreed threshold while preserving the agreed energy reserve for the specified backup duty.

This statement gives finance a traceable benefit event, gives engineering a measurable AC target and gives suppliers a shared basis for dispatch logic.

What to Include in a Nigerian Commercial BESS Quote

A complete comparison separates factory-supplied equipment from EPC and site responsibilities.

Scope areaFactory proposal should identifyEPC or site party should identify
Battery and PCSModel, quantity, rated kW/kVA, rated kWh, operating limits, BMS/EMS interfaceFinal duty cycle, selected location and access route
AC interfaceTerminals, voltage, current, transformer data and protection interfacePCC breaker, downstream switchgear, cable route and relay coordination
Enclosure and thermal systemIP rating, cooling method, auxiliary loads and service accessFoundation, drainage, canopy decision and ventilation around equipment
ControlsEMS communication protocols, meter data requirement and operating modesNetwork ownership, remote-access policy and local control authority
CommissioningFAT evidence, site test boundary and documentation packageUtility coordination, electrical permits, field installation and witnessed energization
LogisticsFactory packing list, lifting points and shipment interfaceLocal customs, offloading equipment, road access and site lifting plan

Use the C&I BESS procurement checklist to keep technical and commercial assumptions in one comparison file. The product proposal, freight, local installation, external cable works, utility application, civil works and commissioning scope should each have an identified owner.

Verify PCS, BMS and EMS Interfaces Before Purchase Approval

Control integration defines whether a well-rated battery system serves the intended operating event.

The PCS and BMS integration review gives useful questions for this check. The key document is the project communication matrix, since it connects physical equipment ratings with the actual operating logic.

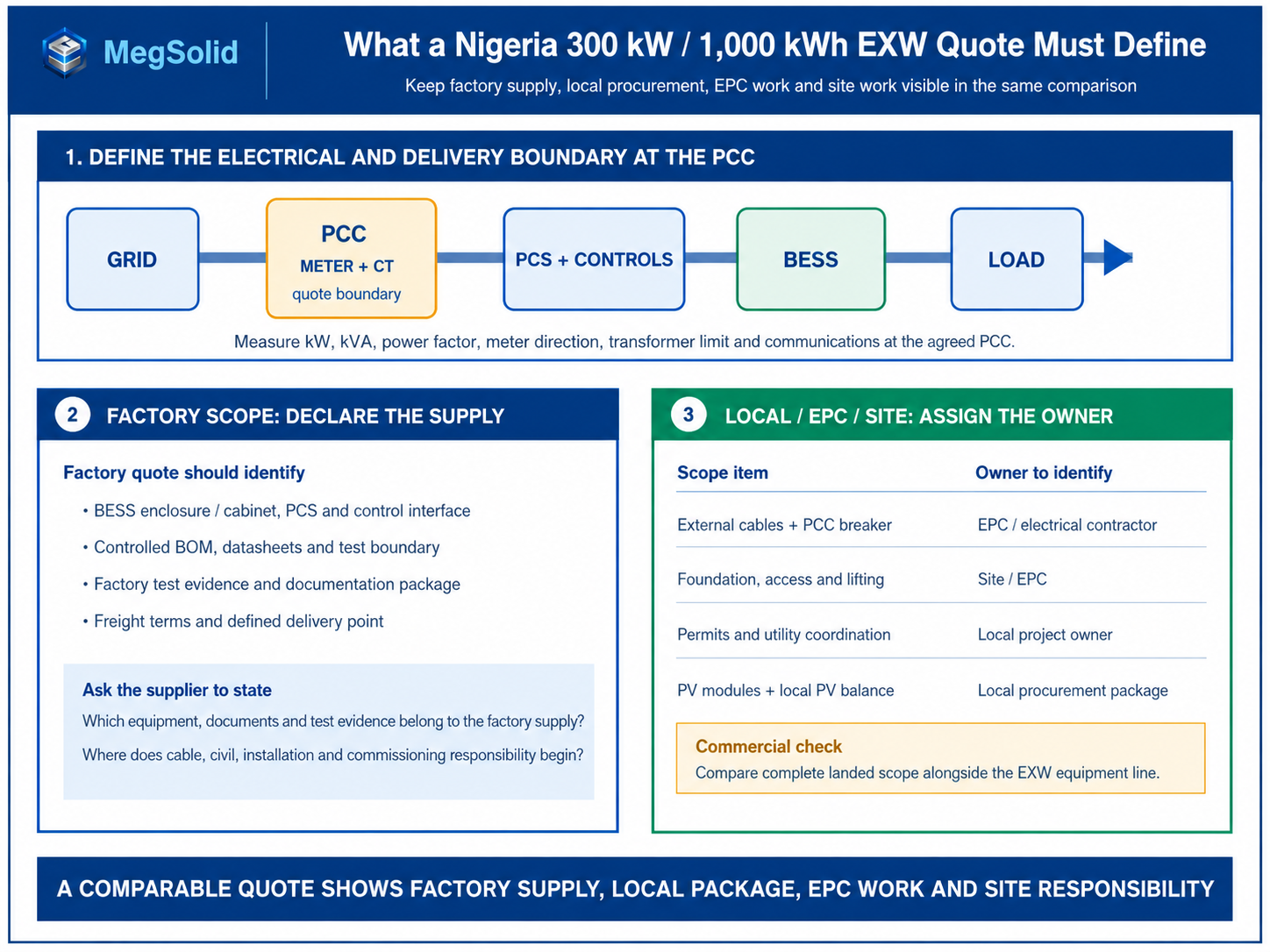

EXW commercial BESS quote scope infographic for Nigeria showing PCC boundary, factory supply, local procurement, EPC work and site responsibility

Use Acceptance Evidence to Protect the Commercial Decision

Commissioning evidence should test the declared project duty rather than a generic cabinet demonstration.

The BESS factory acceptance witness checklist can be adapted to the defined factory boundary. Site acceptance should then validate the installed cable path, PCC behaviour, controls integration and operating duty.

Choose the Next Commercial Action

The next step is a concise project data pack that lets the technical and commercial teams prepare a comparable proposal.

For an EPC evaluation framework, see how EPCs evaluate energy storage systems in project deployment. For country-specific supplier due diligence, use battery energy storage supplier evaluation in Nigeria.

FAQ

300kW is the active AC power the system must deliver or manage at the declared electrical boundary. The required power factor, current, surge duty and control mode belong in the project specification.

The nominal quotient is 3.33 hours. Final duration comes from the project duty-cycle calculation and declared operating reserve.

Specify both when site power factor affects the duty. kW defines active power, while kVA defines apparent power and equipment current capability.

Provide interval load data, a single-line diagram, PCC and transformer information, operating schedule, source information, site layout and responsibility matrix for external works.

Grid-connected operation depends on the PCC characteristics, utility requirements, selected PCS control mode, protection coordination and approved installation design. These inputs require site-specific confirmation.

The quote depends on PCS power, battery energy, operating duty, transformer and switchgear interface, cables, controls, enclosure, thermal system, delivery terms, commissioning and local EPC works.

MegSolid (Hong Kong) Limited focuses on the R&D, design and supply of high-performance energy storage systems. With ten years of technical accumulation, we offer customized outdoor cabinet ESS, residential inverters and portable power solutions for global clients.
WhatsApp/Wechat: +852 59811073

Get Your MegSolid Energy Storage Solution in 24 Hours

Direct from a Solid-State Battery Manufacturer. Receive a customized ESS proposal, ROI analysis, and system recommendation from our engineering team.

What You'll Receive

Trusted Worldwide:

UL, IEC, UN38.3,China Classification Society,GB36276-2023,RoHS

Hot Models:

Applications:

Factories · Solar Farms · Mining · Islands · Data Centers

Tell us your project — we'll design the system for you.
